Seadown Water Scheme Upgrade

Water Supply

What's happening now?

SEADOWN WATER MAIN - Stage One Update 13/02/25

Stage one of the Seadown trunk main, from the pump station to Foley – Naughton Road corner, was completed and commissioned at the end of December 2024

An initial group of 10 tank connections have been batched in the first lot of property connections to the new main. This has been submitted for pricing and approval after which the work will begin installing those connections.

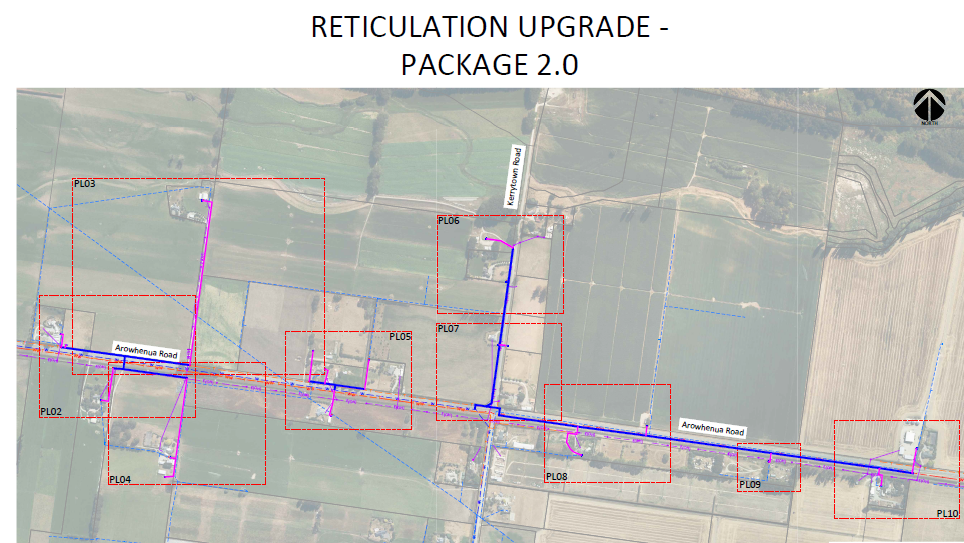

Batch 2 along Arowhenua road, from Mill road to Kerrytown road, is currently in process.

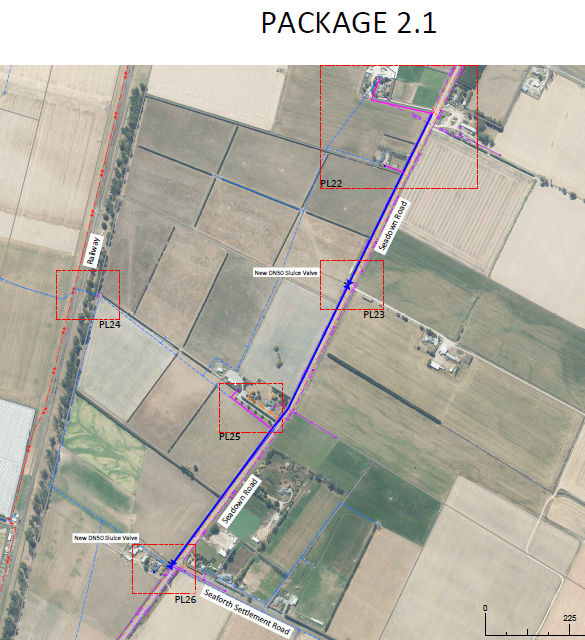

Stage two of the Trunk main upgrade from Foley Road onward is in the design phase.

June 2024

Work will shortly begin to install the new trunkmain that will supply the Seadown scheme. We will be reaching out to the residents and landowners that are affected as part of Stage One of this upgrade with the next steps and what will be required going forward.

Once the installation of the trunkmain is established we can proceed with engaging with residents of stage two. (the rest of the scheme)

Seadown Upgrade Stage One Location:

SEADOWN WATER MAIN - Stage One Update

Stage one of the Seadown trunk main, from the pump station to Foley – Naughton Road corner, has now been completed and commissioned.

An initial group of 10 tank connections have been batched in the first lot of property connections to the new main. This has been submitted for pricing and approval after which the work will begin installing those connections.

Batch 2 along Arowhenua road, from Mill road to Kerrytown road, is currently in process.

Stage two of the Trunk main upgrade from Foley Road onward is in the design phase.

Background

Back in January 2022, consultation was done regarding the future of the Seadown water supply.

We received a total of 59 submissions and it was great to see thoughtful consideration of the issues. The feedback we received was consistent with the discussions at our in-person meetings held in November 2021, which over 100 people attended. (Please see the full consultation document and results below)

Based on feedback, Council decided at its Infrastructure Committee meeting on 26 August 2022 to reconfigure the scheme over time to convert it to a fully restricted trickle-feed supply. This will address the issues of equity and fairness, while also improving scheme performance in terms of flow and pressure, and will make it consistent with Council’s other rural water supplies such as Te Moana and Downlands.

These changes to the scheme were proposed to be developed and coordinated with scheduled asset renewals over an extended period of time, such as the next 10 years.

View the 2022 Public Consultation document here:

Frequently Asked Questions

I have a question that I can't find the answer to, how do I get in touch?

Please email all enquiries to seadown@timdc.govt.nz and we will be in touch as soon as possible.

What size water supply tank will I need?

A minimum of 30,000 litres or 3 days storage supply on your current allocation, whichever is greater. Use the water supply calculator below to determine your supply. This can be a single tank or several tanks connected together to achieve the 30,000 liters capacity.

I currently have troughs on my property that are directly connected to the Seadown scheme watermain, can they remain?

No. Troughs will not be allowed to connect directly to a watermain. You may keep the number of troughs you have but they must be supplied directly from your one principal tank.

 Will I need to relocate my tank or install a pump?

Possibly, this will depend on your individual set up. At this stage we are aware that the best location for your tank would be as close to the roadside of your property boundary, adjacent to the main as possible. If you have questions on this send them to seadown@timdc.govt.nz

I need to install a new pump or have my current one relocated, who can do this?

It is essential that a Council approved contractor does this. To find a list of suitable contractors visit: www.timaru.govt.nz/approvedcontractor (Refer to the contractors highlighted in green for the work required)

How much water am I entitled to?

65 litres per hectare per day for stock water, with an additional 1,000 litres per dwelling per day. To work out the maximum number of units you’re eligible for, use the water supply calculator below under "Resources".

Was this consulted on?

Yes, please see the 2022 consultation document here:

and the consultation results here:

Will you be digging up my property?

No,  the installation of the new pipes will be within the road corridor.

We will need to trench from the road to your tank in consultation with you.

In very few instances we may need to trench across your property to supply neighbours.

We will consult with you in these situations.

 When do I need to have the works on my property completed by?

Stage one properties are required to be hooked up to the new main by July , 2025.

Stage two completion date is undetermined at this time.

Why does the scheme need to change?

As it is currently, the Seadown water scheme doesn't meet the standards set by Taumata Arowai, New Zealand’s water regulator. These upgrades will ensure that all properties are connected to the same scheme style as other rural schemes managed by Timaru District Council. This will improve scheme safety, address demand issues, and ensure there's consistent water for all users.

Resources

Seadown Water Web Page: Seadown Water Supply - Timaru District Council

Water Calculator: Seadown water supply Calculator - Timaru District Council

Property Search  Property Search - Timaru District Council

Approved Contractors (Contractors that can be used for these works are highlighted in green) : www.timaru.govt.nz/approvedcontractor

Contact: seadown@timdc.govt.nz

Last updated: 20 Feb 2025
